Electrical Safety Equipment for Substation & Switchgear Work

Substation work is a sequence, and the equipment follows the sequence: isolate, prove dead, earth and short-circuit, work from a protected position, then account for every tool. Getting one step wrong is what turns a routine job into an incident.

Home/Application

The worksite as a sequence

The first step is isolation, and the second is not optional: proving the circuit dead at the point of work. That is where a voltage detector enters the specification, and why the detector has to suit the network and the point of work rather than the whole range of voltages the site happens to contain.

The third step is earthing and short-circuiting, so that the conductor is held at earth potential and protected against a re-energisation or an induced voltage while the crew is on it. The fourth is the position the crew works from — the mat they stand on, the ladder or platform they reach from. The fifth is the tool account: on a switchgear job, the check that every tool is back in its place is the same check that confirms nothing has been left inside the equipment.

What changes between a 10 kV board and a 110 kV station

Voltage does not scale the equipment in one dimension, and the two halves scale differently. The insulating side — the mat class, the insulation distance on a clamp, the length of an operating rod — grows with the installation voltage.

The current-carrying side does not work that way at all. A portable earthing set is rated by current, time and peak factor, and its withstand capability does not carry a rated voltage: the prospective fault current at the worksite and the clearing time of the upstream protection are what size it, while the installation voltage sets the insulating component and the geometry. A station close to generation and the far end of a feeder on the same network can need different sets at the same nominal voltage.

  • Insulating matting to IEC 61111, selected by the class required for the installation
  • Voltage detectors to IEC 61243-1, chosen from the network and the point of work

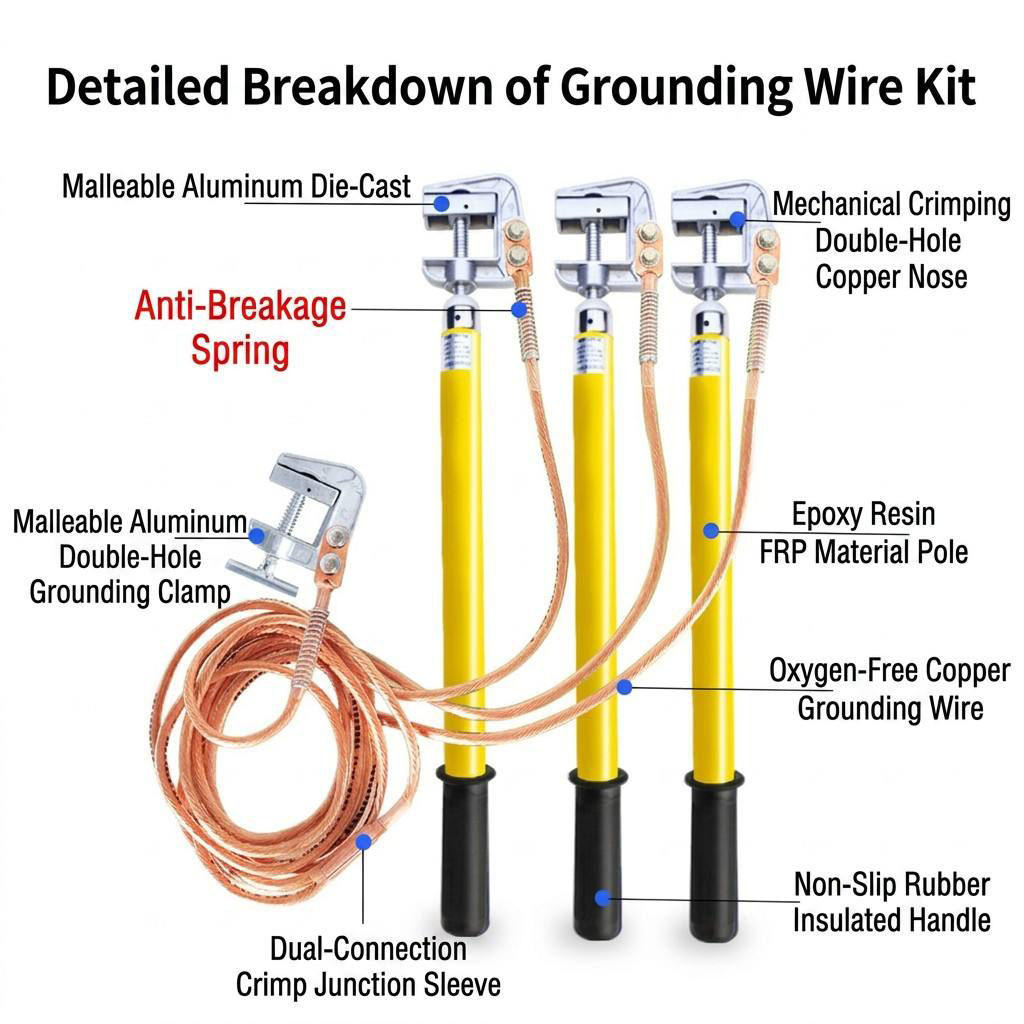

  • Portable earthing and short-circuiting sets to IEC 61230
  • Insulating gloves to IEC 60903 and insulated footwear to EN 50321-1
  • Insulating ladders, platforms and operating rods
  • Smart tool cabinets with position control and an issue record
  • Substation safety signage and route markers

The three documents an inspector asks for

On a substation job the paperwork is part of the equipment. Three documents come up again and again: the batch test report for the matting, which is why matting is dielectric tested in our own factory before dispatch and the report travels with the batch; the rated values of the earthing set — current, time and peak factor — because those are what the set is actually rated by; and the tool cabinet record, because a permit-to-work asks who took what and when.

If your procedure requires a specific document format or a specific test class on the certificate, say so at the quotation stage. Producing the right paperwork afterwards is the expensive way to find out.

Where the range covers a substation

A full substation package from one manufacturer means the parts cannot turn out to be mutually incompatible on site. The products below are the ones most often specified together; each links to its own page with specifications and test documentation.

Equipment for this worksite

Products specified on substation & switchgear work

FAQ

Frequently asked questions

How do I size a portable earthing set for our substation?
From the prospective fault current at the point of work and the clearing time of the upstream protection, under IEC 61230 — not from the system voltage. Send us the fault level, the conductor type and the earthing arrangement actually in use, and we will confirm the cross-section and the clamps.
Which class of insulating matting do we need?
The class follows the maximum service voltage of the installation — normally the phase-to-phase voltage on a three-phase circuit, and the phase-to-earth figure only where the exposed work is genuinely limited to one phase. Thickness follows from the class inside the standard, so tell us the network voltage and the standard you are specifying against.
Can we get a test report per batch rather than per delivery?
Yes. Matting is dielectric tested in our own factory before dispatch and the relevant batch test report is supplied with the shipment. Tell us at the quotation stage whether your inspector needs a batch report or a type test report — they are not the same document.
Do the tool cabinets come configured to our tool list?
Yes. Cabinets are configured from your tool inventory — sizes, quantities and access method — rather than supplied as a fixed kit, and they record who took what and when so the record can be produced for a permit-to-work.
